Meet the future of foundations.

Every component has one purpose. Maximum strength. Minimum complexity.

No excavation. No concrete curing. No waiting weeks.

Designed to scale. From one home to entire communities.

Because projects shouldn't wait for foundations.

The future isn't built from the top down. It begins underground.

Scroll to find out

Scroll to find out

Engineered. Tested. Supported.

Incubation, grant funding and research partnerships behind the pre-engineered nail foundation — from national institutes, government innovation programmes and climate funds.

For a century a foundation meant digging, pouring and waiting. PEN drives four nails instead and carries the load the same day.

Three weeks of your programme are spent waiting for concrete to cure

A cast-in-situ footing has to be dug, formed, poured and then left alone for 21 days before anything can be built on it — and each point displaces 2–3 m³ of spoil on the way. PEN Foundation is a patented alternative that is driven in about two hours, carries structural load immediately, and moves no soil at all. What that changes on a real project:

  • Installed in ~2 hours. No curing. Load-bearing immediately

  • Zero excavation — soil stratification and groundwater flow preserved

  • Four battered GI nails transfer load through skin friction

  • Enhancement Factor of 2.0–2.6× SBC, field-validated at NIT Calicut

  • Governed by IS 2911 Part 4 — Factor of Safety 2.0–2.5

  • Over 80% less concrete. Components recoverable at end of life

One precast node. Four driven nails.

PEN Foundation is a pre-engineered replacement for a cast-in-situ footing: a factory-made concrete node that sits on the ground, anchored by four galvanised steel nails driven into the soil around it at an angle.

One precast node
M50 concrete, cast and cured in the factory — nothing is mixed or formed on your site.
Four battered nails
Driven at 40–51°, engaging a soil volume far larger than the node’s own footprint.
2.0–2.6× bearing capacity
Enhancement Factor, confirmed by field plate load tests at NIT Calicut.
Zero curing
Load-bearing the moment the last nail is driven and grouted.

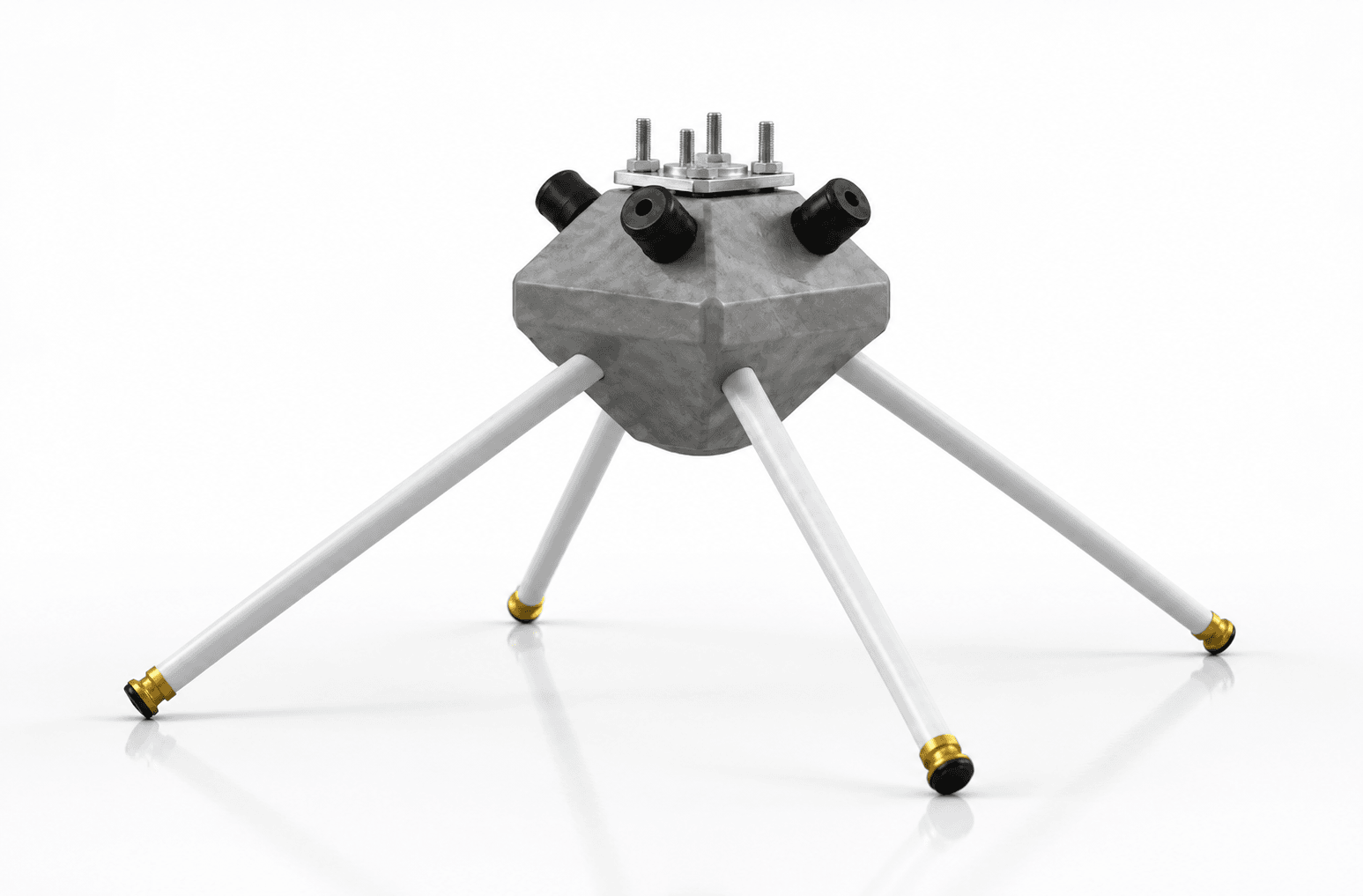

The PEN Foundation node: a precast concrete block with a bolted top plate and four galvanised steel nails splayed at a batter angle, tungsten carbide tips at their ends

A conventional footing works by bearing: its weight presses down on the soil directly beneath it, and its capacity is limited by what that patch of ground can carry. PEN works by friction. Load entering the node splits into four paths and travels down the nails, shedding into the soil along their whole embedded length — the same way a tree resists wind through its roots rather than by sitting heavily on the ground.

Because the four nails are driven apart at a batter, they engage a three-dimensional volume of soil far larger than the node’s own footprint. Non-shrink grout pumped down each pipe locks it to the ground along its length. That is where the measured capacity gain comes from: an Enhancement Factor of 2.0–2.6× the soil’s bearing capacity, confirmed by field plate load tests at NIT Calicut.

“Pre-engineered” is literal. The node is cast and cured in the factory to a fixed model and dispatched ready to use, so nothing is mixed, formed or cured on your site. What is engineered per project is the layout and the driving: the number of points, and a batter angle set between 40° and 51° to suit the ground it is going into.

PEN Foundation and a conventional footing, side by side

Property

PEN Foundation

Conventional footing

Load-bearing the day it is installedYesNo
Zero excavation, no spoil to dispose ofYesNo
No wet concrete cast on siteYesNo
No water needed for installationYesNo
Installs on disturbed or sloping ground without excavationYesNo
Components recoverable at end of lifeYesNo
Designed to an Indian Standard codeYesYes
Capacity verified by on-site plate load testingYesYes
Suitable for permanent structuresYesYes

PEN is governed by IS 2911 Part 4 (nail / pile system); a conventional isolated footing by IS 6403. Both are designed to code — the difference is which one, and what the ground has to go through to get there.

See PEN in the ground

  • 01The system

    One node, four nails

    The precast node and its four battered nails, before they go into the ground.

    Studio render of the PEN node with four galvanised nails splayed at a batter angle
    See the system
  • 02What it replaces

    The conventional way

    Deep excavation, rebar cages and three weeks of curing before anything is built.

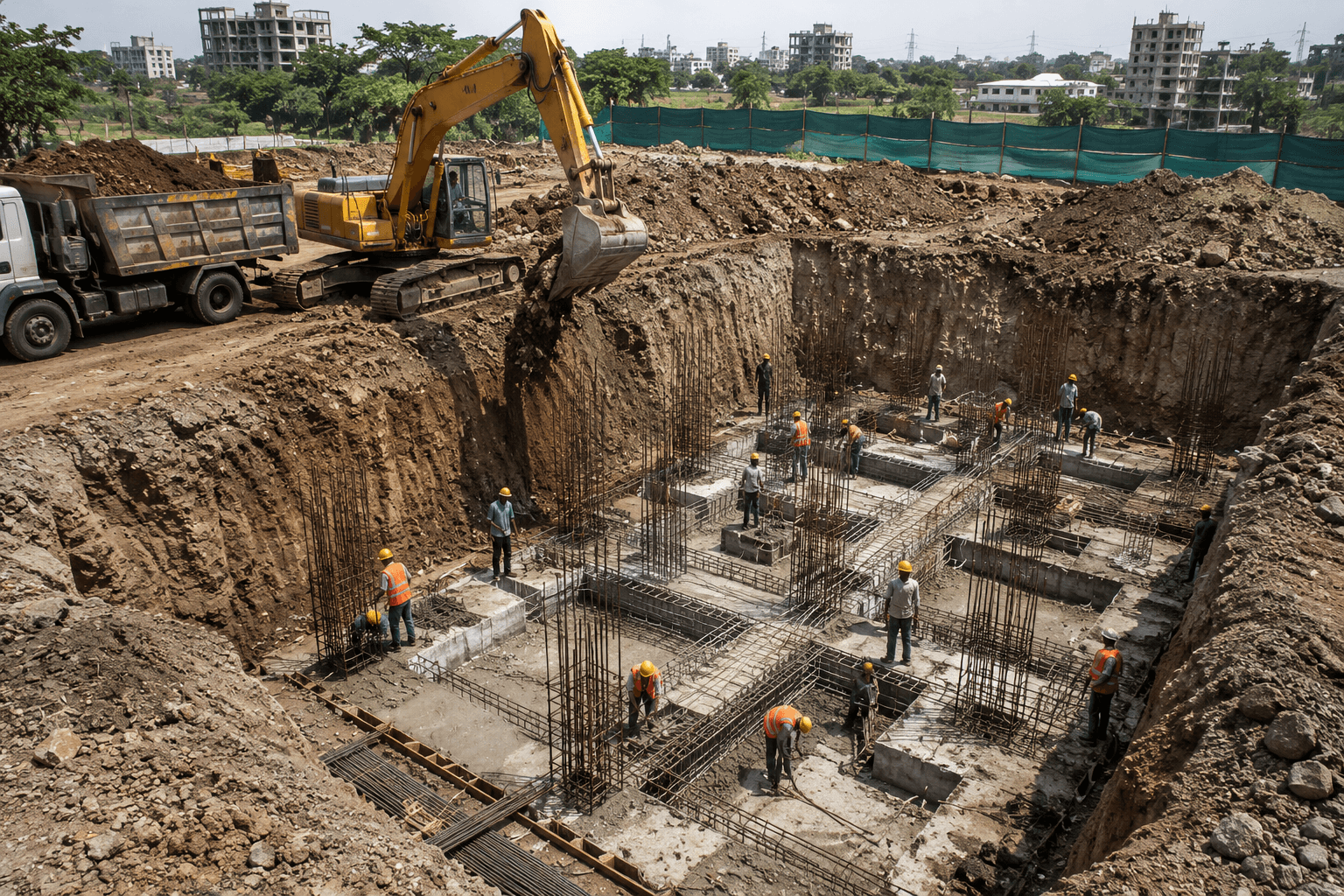

    A deep excavation with reinforcement cages, an excavator and a spoil truck on a building site
    See what it replaces
  • 03On site

    Structure the same day

    The superstructure bolts straight to the node — no curing wait in between.

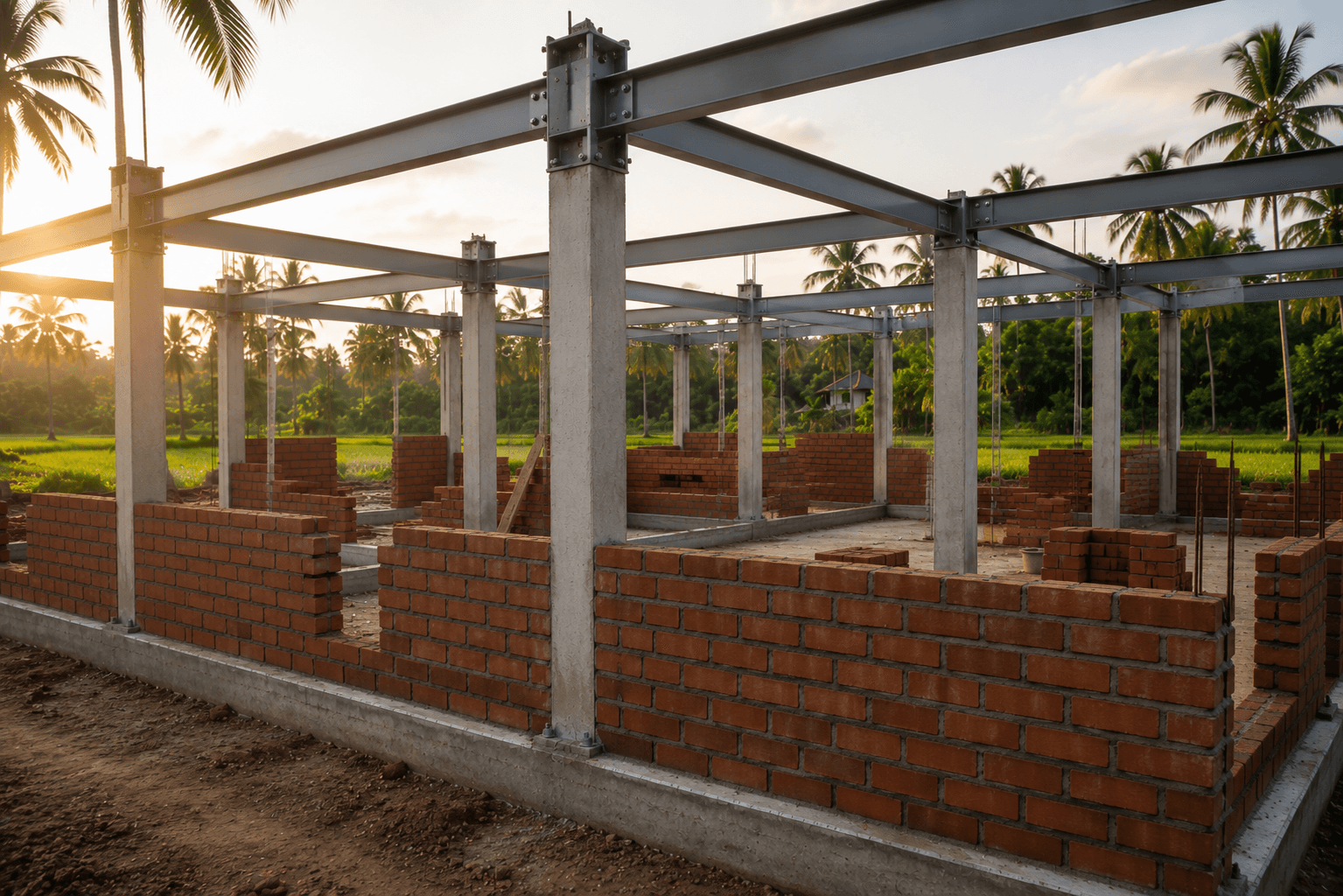

    A steel and masonry structure standing on completed PEN foundations at a Kerala site
    See the projects

Four steps from site visit to structure

PEN is specified per project, not sold off a shelf. The layout, the point count and the driving depth all follow from what your ground and your structure actually need.

  1. 01

    Assess

    We look at the project, the site and the loads it has to carry. Soil condition matters most — laterite, black cotton, sandy, rocky and high-water-table sites each behave differently, and each changes how the system is set out.

  2. 02

    Engineer

    Our engineers size the solution: how many foundation points, where they go, what batter angle and embedment depth suit the ground. The design is worked to IS 2911 Part 4, with a Factor of Safety of 2.5 on a single plate load test or 2.0 where two or more are run.

  3. 03

    Install

    Nodes are placed on the surface and the four nails are driven and grouted — around two hours per point, with no digging, no formwork and no water trucked in. There is no curing wait at the end of it.

  4. 04

    Build

    The superstructure bolts to the node through an M12 galvanised connection and work continues the same day. On a conventional footing this is where three weeks of waiting would start.

Where PEN is being specified

PEN suits structures where the foundation is repetitive, the programme is tight, or the ground should not be dug. These are the categories the system is built and sold for today.

  • Low-rise residential

    G+0 and G+1 homes. A typical G+1 house needs roughly 16–20 PEN units, set in a day rather than staged over a month.

  • Low-rise commercial

    Small commercial buildings where every week of programme carries a holding cost, and where a clean site matters to the neighbours.

  • Low-span industrial

    Sheds and light industrial buildings on regular column grids — the repetition is what makes a pre-engineered point economical.

  • Modular and relocatable homes

    Prefab and modular structures. Components are recoverable at end of life, so a relocatable building can take its foundation with it.

  • Resorts and hospitality

    Ecologically sensitive sites. Zero excavation keeps root systems, soil layers and slopes intact — which is often what the approval depends on.

  • Farm structures

    Agricultural buildings on soft or seasonal ground, away from batching plants and water supply.

  • Mass housing and shelters

    Housing programmes at volume, including rehabilitation work on ground too disturbed for conventional excavation.

  • Disaster rehabilitation

    Quick temporary shelters, where the foundation cannot be the thing that delays occupation.

  • Compound walls and fencing

    Boundary walls and fence lines — long runs of small, identical, repeated foundation points.

PEN is engineered for low-rise construction. Structures above G+2 are on the development roadmap, not in the current product. Every project is assessed on its own soil data and loads before the system is specified.

Built across soils, seasons and states

  • Devagiri Library

    Calicut, KeralaRetrofit under an occupied building

    Challenge
    Foundations had to go in underneath an existing, occupied building. No tolerance for vibration or structural disruption, and the existing flooring could not be broken.
    Result
    Installed without disrupting the structure above. The building stayed operational throughout, with zero downtime. The project went on to win Best Steel Structure in India at SSMB 2024.
    The Devagiri Library at night: a tall cylindrical reading tower in a black steel grid, lit from within, with a figure walking past at ground level
  • Black Langur Resort

    Wayanad, KeralaEco-resort in dense forest

    Challenge
    A dense forest site with live root systems of protected trees close to every foundation point, under a forest department zero-excavation mandate.
    Result
    Every foundation installed without disturbing a single root system. Forest department approval retained and the site left undisturbed after installation.
    Visualisation of the Black Langur Resort: a two-storey block with a tiled roof and pool, built among standing jackfruit trees
  • Startup EcoAshram

    Kudal, MaharashtraFirst commercial-scale deployment

    Challenge
    The first deployment at commercial scale — over 200 foundation units on one site, outside Kerala and outside laterite soil.
    Result
    Delivered as a single commercial-scale installation, taking PEN from pilot projects to repeatable volume.
    A pavilion at Startup EcoAshram: a curved shingled roof over white walls, raised above a wooded slope on a splayed bamboo frame
  • Rehabilitation Housing

    Wayanad, KeralaPost-landslide housing

    Challenge
    A post-landslide slope in unstable laterite. Conventional foundations were not an option — the ground was too disturbed to excavate.
    Result
    PEN foundations installed on the active slope within 72 hours of site clearance, load-bearing immediately with no curing wait on unstable terrain.

Field-tested at NIT Calicut, mentored by IIT Kanpur, listed by GRIHA

What could PEN mean for your project?

Set the number of foundation points and the project type to see the programme time and site cost PEN removes. The estimate uses Kerala project averages — for a figure against your own drawings and soil data, ask for a project assessment.

Project Parameters

4
Project type

Based on Kerala project averages.Traditional: 2.1 days/point · PEN: ~2 hours/point.Cost saved: ₹45,000/point on excavation, spoil and curing time.CO₂: 106 kg/point, ≈5 trees — IKEA Foundation case study.Project type scales time and cost. Carbon is per unit, so it does not.Indicative only — not a quotation.

8 days

Time Saved

That's 1.1 weeks off your programme

₹1.8L

Cost Savings

Saved on excavation & curing

424 kg

CO₂ Avoided

Equivalent to planting 20 trees see what goes into the ground

Tell us about your projectand we will tell you if PEN fits

Our engineers will review your site and loads and come back with whether the system suits the project — and if it does not, we will say so.

Prefer speaking with an engineer?

+91 7356177577

FAQs

The answers below come from the test reports and the technical specification. Where the honest answer is “it depends on your site”, it says so.

Ask an engineer directly

A patented pre-engineered nail foundation: an M50 precast concrete node, 450 × 450 × 200 mm, anchored by four galvanised steel nail pipes driven into the surrounding soil at a batter and grouted in place. It replaces a cast-in-situ isolated footing.

A conventional footing is dug, formed, poured and cured over 21 days or more, and its capacity depends on the soil directly beneath its base. PEN is driven in about two hours per point, needs no excavation and no curing, and transfers load through skin friction along four nails — giving a field-validated Enhancement Factor of 2.0–2.6× the soil bearing capacity.

The node is cast and cured in the factory to a fixed model, CD-PEN-32.3.2.1500, and arrives ready to use — nothing is mixed, formed or cured on your site. What is engineered per project is the layout and the driving: the point count, the embedment and a batter angle set between 40° and 51° for your ground.

An M50 precast concrete node, four GI pipes at 32 mm OD with a 3.2 mm wall to IS 1239, recycled tungsten carbide penetration tips, Fosroc Conbextra GP2 non-shrink grout, and M12 grade 4.6 galvanised bolts to IS 5624 for the superstructure connection.
